Large Power Solutions
Large Power Application Fees for electric services above 500KW have been updated effective September 1st, 2025. Click to see new fees
Meeting the needs of Grant County’s largest customers
Grant PUD’s Large Power Solutions (LPS) team supports customers with electrical demand of 500 kW (0.5 MW) and above. We serve as your single point of contact, helping you plan, expand, and manage large power service from early inquiry through energized service.
Who this is for:
- Customers using 500 kW (0.5 MW) or more
- New large‑load customers locating in Grant County
- Existing customers expanding electric service
- Industrial and commercial customers
Planning a New or Expanded Service?
Start a Large Power inquiry and learn about the large‑load service process
Who do I contact for questions regarding new or expanding service?
Please contact Katherine Taiclet, Grant PUD's Business Development Manager by e-mail: ktaiclet@gcpud.org, or call 509-702-0126

*Port Districts follow a slightly different process.

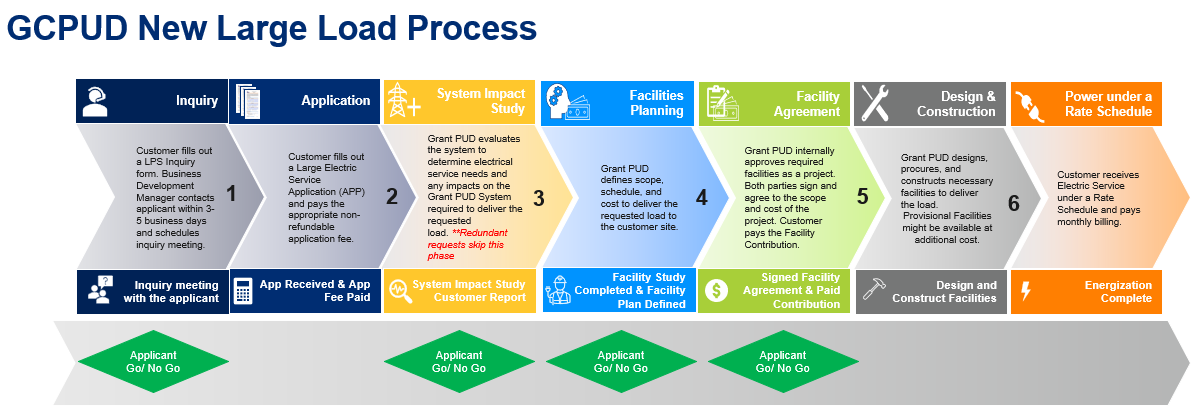

1. Inquiry & Initial Consultation
Customer submits an LPS inquiry form and meets with Grant PUD's Large Power Solutions (LPS) team.
Our team will review your proposed project, discuss your power needs, location, and timeline, and answer questions about the application process. This initial consultation helps determine whether the project is a good fit for the existing electric system and identifies any constraints and potential next steps.
2. Application & Application Fee
Customer submits a Large Electric Service Application and applicable fee.
The application provides the information needed to initiate a more comprehensive review of the request. After the application fee is paid and the packet is accepted, the project is assigned a LPS Application ID number and enters Grant PUD's large-load connections process.
3. System Review & Impact Evaluation
Grant PUD evaluates the electrical system and its ability to serve the requested load.
Depending on the size and location of the request, Grant PUD may conduct engineering studies to assess available capacity, identify necessary system improvements, and evaluate impacts on the electric system. Some projects may qualify for previously completed studies and require only limited additional review.
The system study evaluation helps determine the appropriate path to meet the requested load and identifies any infrastructure needed to support the project.
Large load requests are typically handled through the LPS process. Requests for total site ≤2 MW may be coordinated through Commercial Services and, depending on the project's characteristics and service requirements, assigned to a customer service engineer via a work order. If so, steps 4-7 below will differ for these customers.
4. Facilities Planning
Grant PUD develops a preliminary plan to serve the requested load.
This phase identifies the facilities, infrastructure improvements, estimated costs, and construction approach that may be required to provide electric service to the project.
5. Facility Agreement
Grant PUD and the customer finalize project scope, responsibilities, and costs.
A Facility Agreement outlines the infrastructure required to provide service, project costs, customer contributions, and other key terms needed to proceed with construction.
6. Design & Construction
Grant PUD designs, procures, and constructs the required electrical facilities.
Project schedules vary based on facility requirements, equipment availability, permitting, and construction complexity. In some cases, provisional or interim service options may be available.
7. Service Readiness & Required Payments
Complete final requirements prior to energization.
Before electrical service can be energized, all applicable agreements must be executed, required customer contributions must be paid, necessary inspections must be completed, and any applicable deposits must be provided in accordance with Grant PUD policies and rate schedules.
8. Electric Service & Ongoing Partnership
Customer receives service under an approved rate schedule.
Once all requirements are met and facilities are ready for service, Grant PUD energizes the connection and begins electric service under the applicable rate schedule. Grant PUD continues to work with customers throughout operations, growth, and future expansion planning.
Important Note
Large load requests are evaluated in accordance with Grant PUD policies, applicable rate schedules, and available system capacity. Acceptance of an inquiry or application does not guarantee service availability, project approval, or a specific energization date. Project requirements and schedules vary by load size, location, engineering review, facility needs, and construction requirements.
Industry Eligibility
Grant PUD evaluates customer eligibility in accordance with applicable policies, rate schedules, and Board direction. Certain customer classes or industries may be subject to additional requirements, limitations, or temporary restrictions on application processing. Prospective customers are encouraged to contact Grant PUD to discuss current eligibility criteria before applying.
How are my large power rates structured, and what charges make up my bill?

Environmental Attribute Offerings
Interested in learning more about the environmental attributes associated with Grant PUD’s hydroelectric power? See the options below that are available for commercial or industrial customers seeking to support renewable, carbon‑free energy
Contact Large Power Solutions
Have questions for the Large Power Solutions team? Complete the following form and someone will be in touch in the near future.
